Work Order Remaining (Hours/Cycles/Days)

Planning will calculate the W/O Remaining Hours/Cycles and Days based on the time between the Planning Date and the W/O Schedule Start Date.

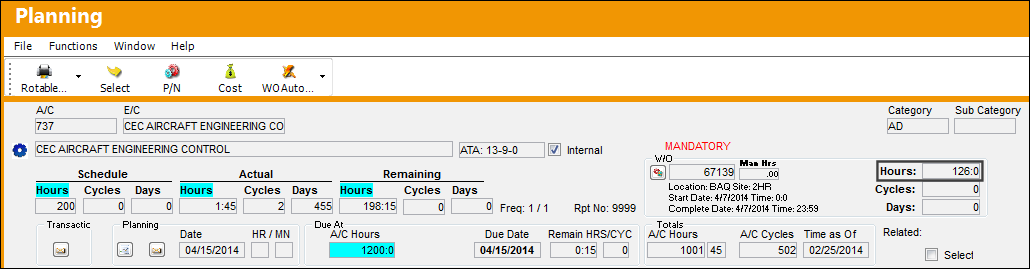

Calculation for Hours Driven E/Cs:

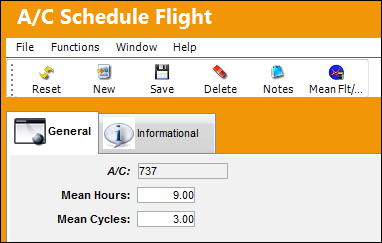

Mean Hours for aircraft 737:

Planning Due Date = 04/15/2014

Planning Date = 03/24/2014

W/O Schedule Start Date = 04/07/2014

Time between Planning Date and W/O Schedule Date = (03/24/2014 - 04/07/2014)

= 14 days

W/O Schedule Start Date

Planning Date

Due Date

04/07/2014

03/24/2014

04/15/2014

Days in between Planning Date and W/O Schedule Date * Mean cycles

14 * 9 = 126



Remaining Hours Bases on the W/O Start Date = 126 hours

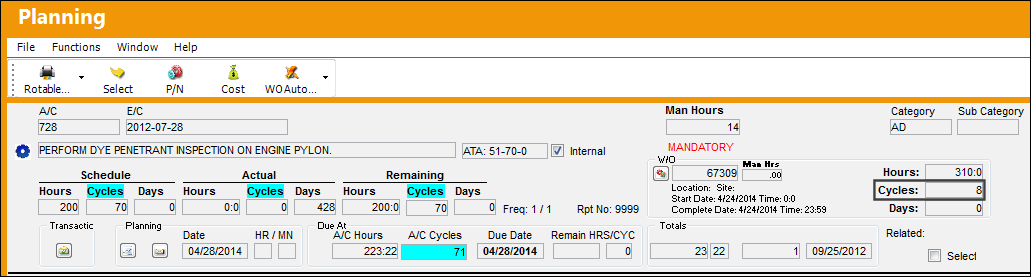

Calculation for Cycles Driven E/Cs:

Mean Cycles for aircraft PH-XRD

Planning Due Date = 04/28/2014

Planning Date = 03/24/2014

W/O Schedule Start Date = 04/28/2014

Time between Planning Date and W/O Schedule Date = (03/24/2014 - 04/24/2014)

= 31 days

W/O Schedule Start Date

Planning Date

Due Date

04/24/2014

03/24/2014

04/28/2014

Days in between Planning Date and W/O Schedule Date * Mean cycles

31 * 2 = 62



Remaining Cycles - 62

70 - 62 = 8

Remaining Cycles Based on the W/O Start Date = 8 cycles

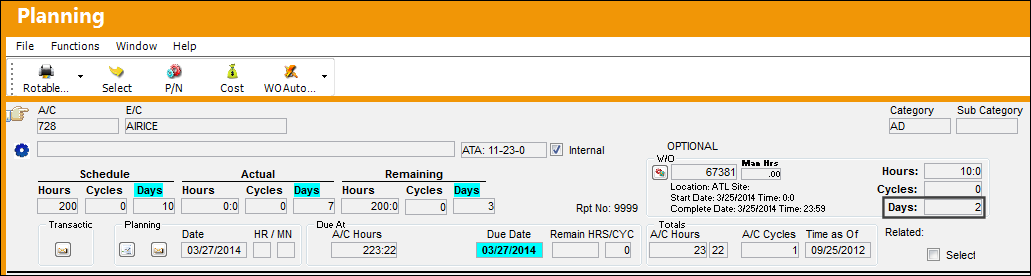

Calculation for Days Driven E/Cs:

Planning Due Date = 03/27/2014

Planning Date = 03/24/2014

W/O Schedule Start Date = 03/25/2014

Time between Planning Date and W/O Schedule Date = (03/24/2014 - 03/25/2014)

= 1 day

W/O Schedule Start Date

Planning Date

Due Date

03/25/2014

03/24/2014

03/27/2014

Remaining Days - Days in between Planning Date and W/O Schedule Date

3 - 1 = 2



Remaining Days Based on the W/O Start Date = 2 days

See Also

Work Order Flag, via A/C Planning Results
