Publication Date: 8/17/2026
Share
Print
|
||||||
AUTOTSKPRIORITY - Enable Auto Task Priority Functionality
Enable Auto Task Priority Functionality

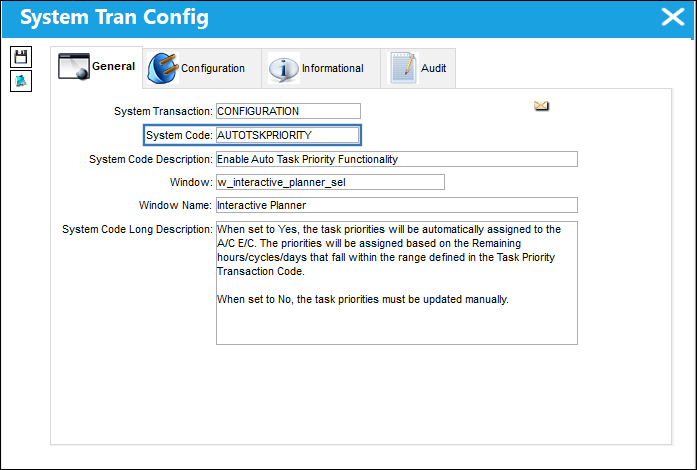

Switch Set to Yes When set to Yes, the task priorities will be automatically assigned to the A/C E/C. The priorities will be assigned based on the Remaining hours/cycles/days that fall within the range defined in the Task Priority Transaction Code.

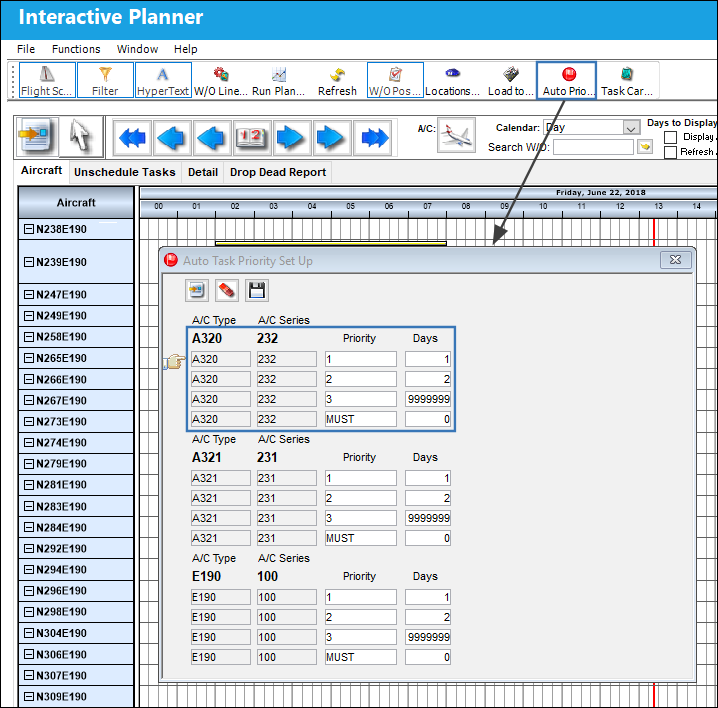

Select the Auto Priority Setup

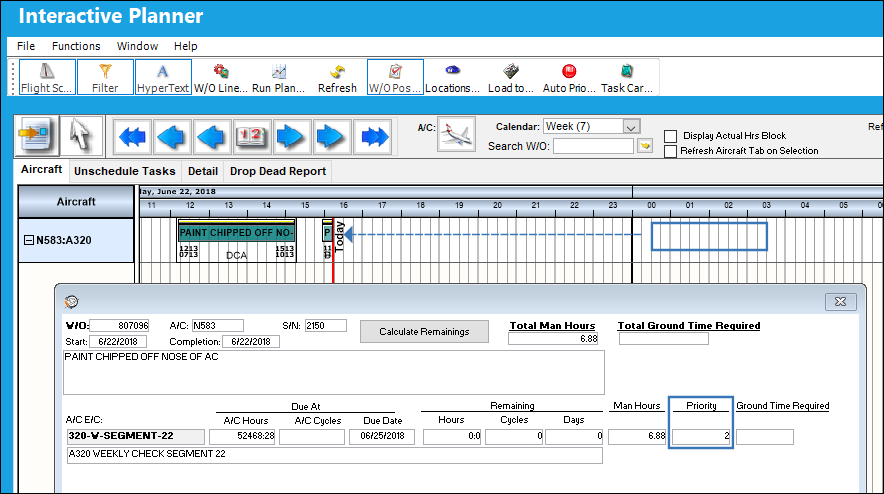

The Work Order in this example has an E/C that is due 06/25/2018. The current date is 06/22/18. The E/C will be due in 3 days, therefore Priority 3 is auto assigned to the E/C. The Calculate Remainings button can be selected to update the information in this window.

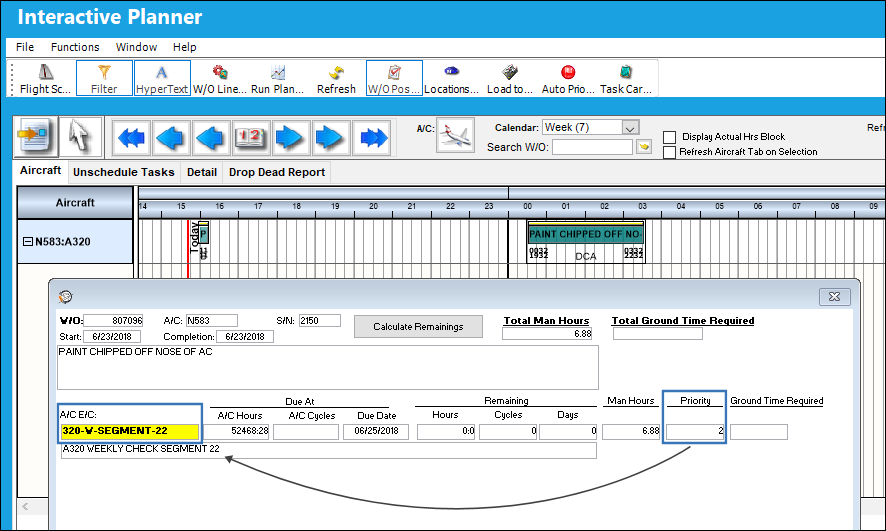

The Work Order is moved to the following day, which is 2 days from the Due Date of the attached E/C.
The Priority is automatically updated to 2. Notice the color of the E/C has been updated as well.
Switch Set to No When set to No, the task priorities must be updated manually.

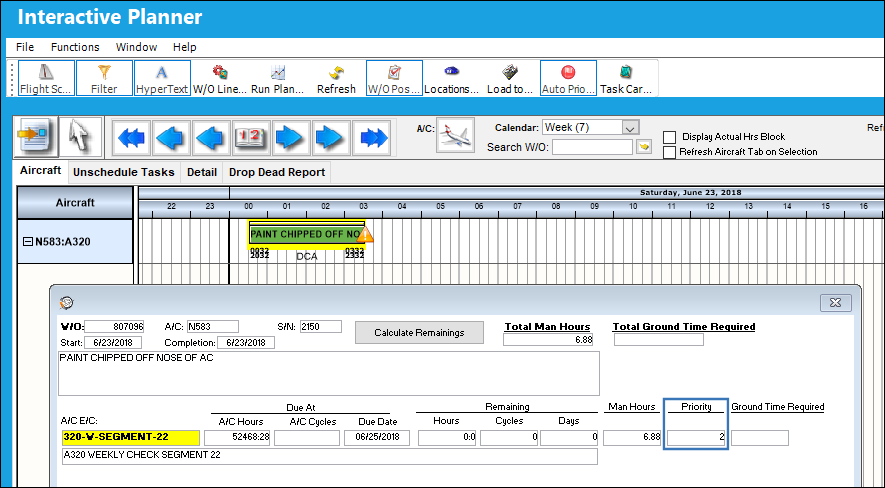

The following Work Order is scheduled for 06/23/18. The E/C for this Work Order is due in 2 days, therefore Priority 2 is auto assigned to the E/C.
The Work Order is moved to the previous day, which is 3 days from the Due Date of the attached E/C. Notice that the Priority of the Work Order E/C has not been updated to Priority 3.
|
||||||
