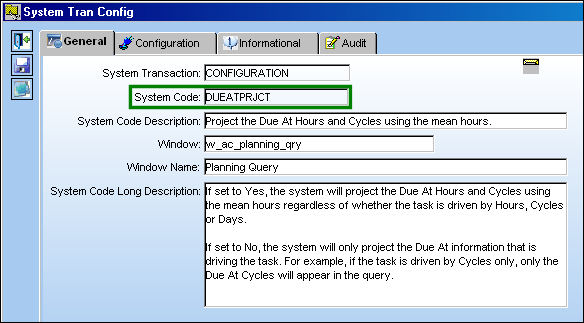

DUEATPRJCT - Project the Due At Hours and Cycles using the mean hours and cyclesProject the Due At Hours and Cycles using the mean hours and cycles Affected Window: w_ac_planning_qry

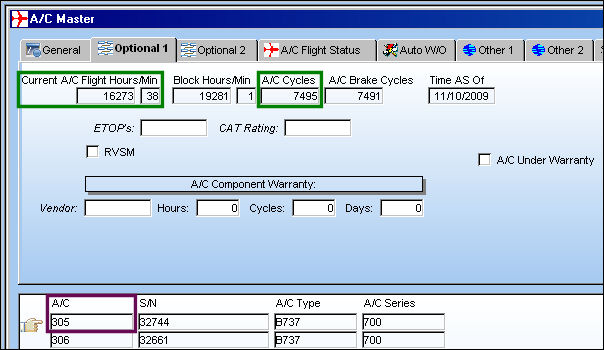

Switch Setup: Aircraft 305 has accumulated 16273 flight hours and 7495 flight cycles:

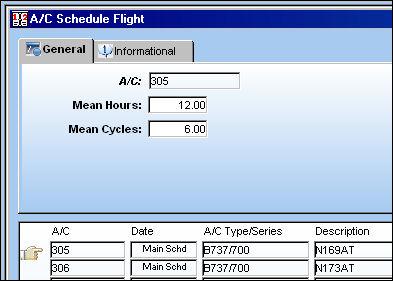

The Mean Hours and Cycles are set up at 12 and 6:

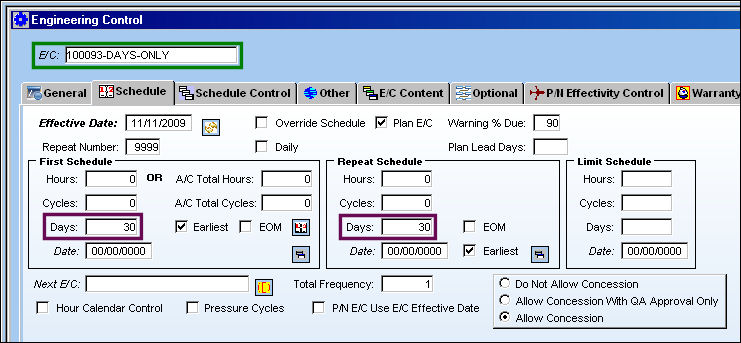

The schedule for the following E/C is driven by Days only:
Switch Set to Yes: When set to Yes, the system will project the Due At Hours and Cycles using the mean hours regardless of whether the task is driven by Hours, Cycles or Days.

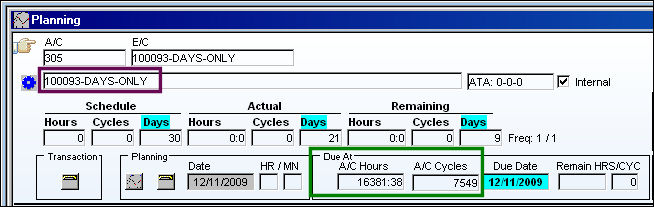

When the A/C Planning Query is run, the Due At Hours and Cycles appear:
Switch Set to No: When set to No, the system will only project the Due At information that is driving the task. For example, if the task is driven by Cycles only, only the Due At Cycles will appear in the query.

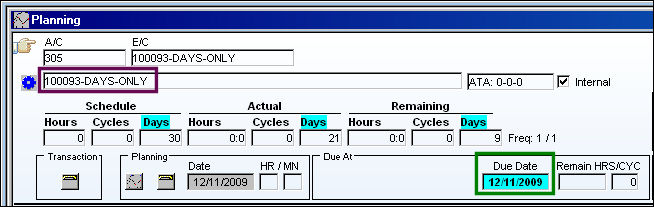

When the A/C Planning Query is run, only the projected date appears:

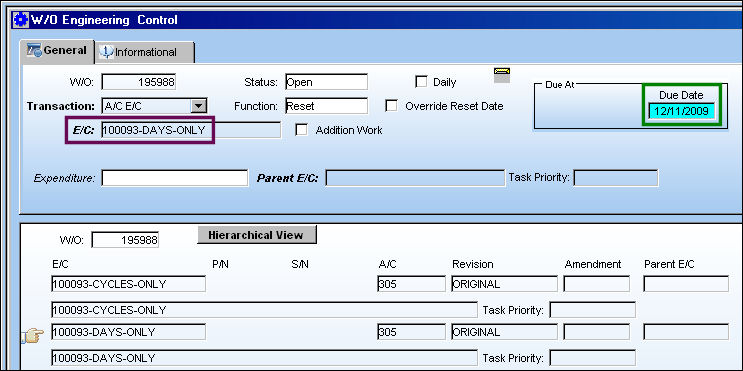

Additional Functionality: When the E/C is added to a Work Order, the E/C reflects the correct information in the W/O Engineering Control window. Also, the driver is highlighted in blue:

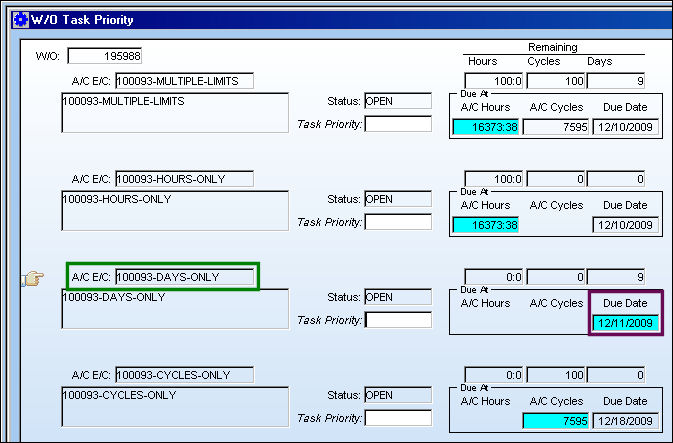

The same information also appears in the W/O Task Priority window:
|
||||||
