FOLLOWGRB - Track E/C Through GRB (Goods Received Batch)
Track E/C Through GRB (Goods Received Batch) Affected Window: w_engineering_eu

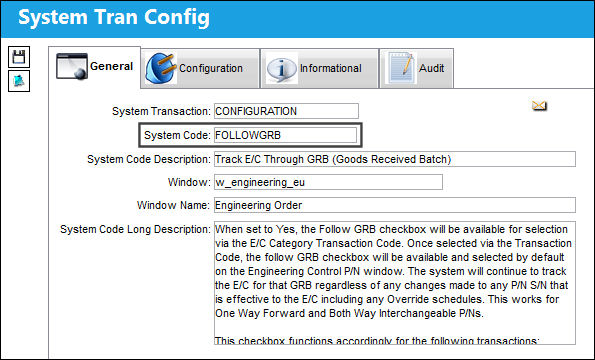

The following three configuration work in conjunction: Inventory switch FOLLOWGRB, the Follow GRB checkbox in the Engineering Control P/N window, and Engineering switch PNSNCHG/EFFECTIVITY. For more detailed information on how these various configurations affect P/N E/C Effectivity, refer to P/N Change Transactions.

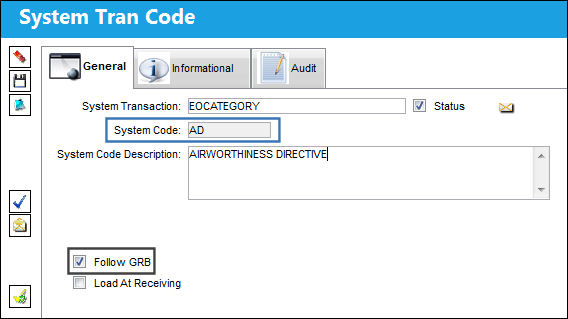

Switch Set to Yes: When set to Yes, the Follow GRB checkbox will be available for selection via the E/C Category Transaction Code. Once selected via the Transaction Code, the Follow GRB checkbox will be available and selected by default on the Engineering Control P/N window. The system will continue to track the E/C for that GRB regardless of any changes made to any P/N S/N that is effective to the E/C including any Override schedules. This works for One Way Forward and Both Way Interchangeable P/Ns. This checkbox functions accordingly for the following transactions:
Also, when set to Yes, the Load At Receiving checkbox will be available for selection via the E/C Category Transaction Code.
The functionality of the Load At Receiving checkbox (via the Engineering Control P/N window) is not new in TRAX Version 11.5. Only the option to have the checkbox selected by default is new. For additional information, refer to the P/N CTL (Control) Button, via the Engineering - E/C Training manual.

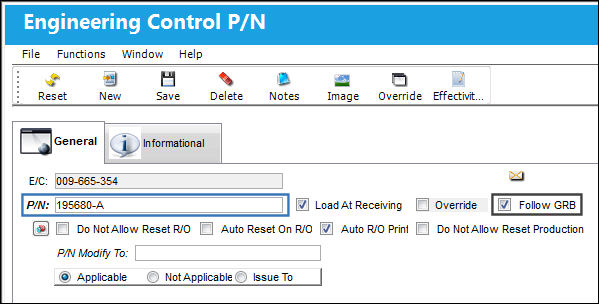

Example 1: P/N S/N Change transaction (Inventory Transaction) The Follow GRB checkbox has been selected for the AD Category Code. Notice that the Load At Receiving checkbox is also available.

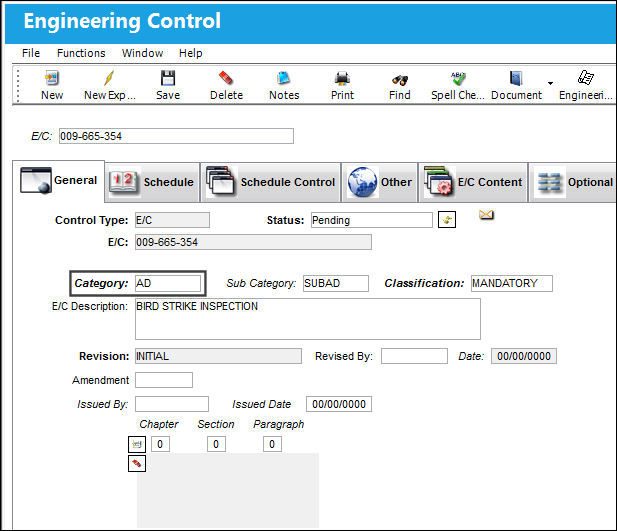

The following E/C was created with E/C Category Code AD:

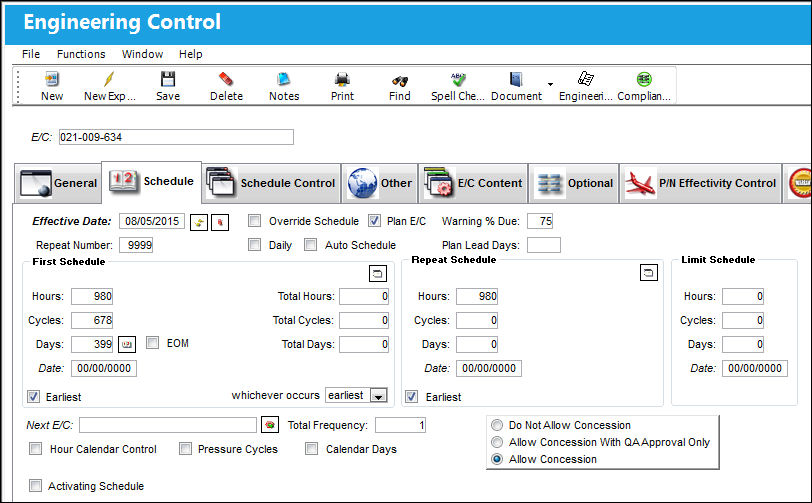

From the Engineering Control P/N window, the Follow GRB checkbox is selected by default.

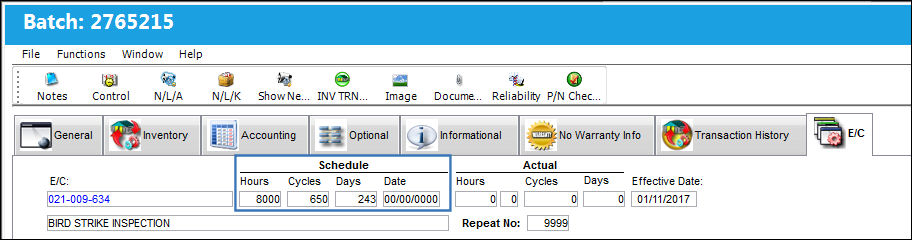

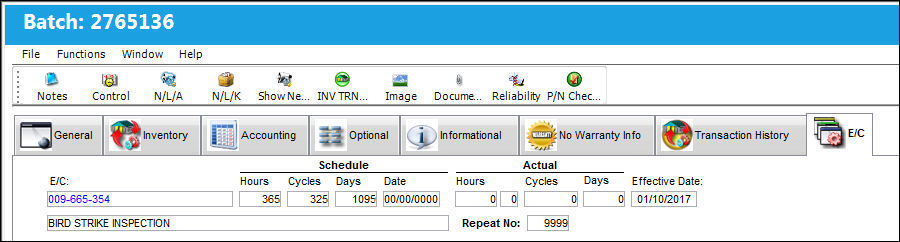

Note the schedule for the E/C:

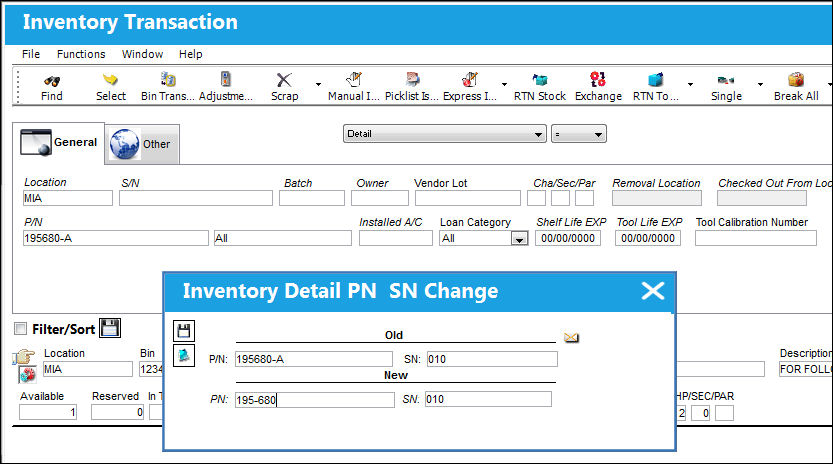

A P/N S/N Change transaction is done for P/N 195680-A. This is the P/N effective to the above E/C.

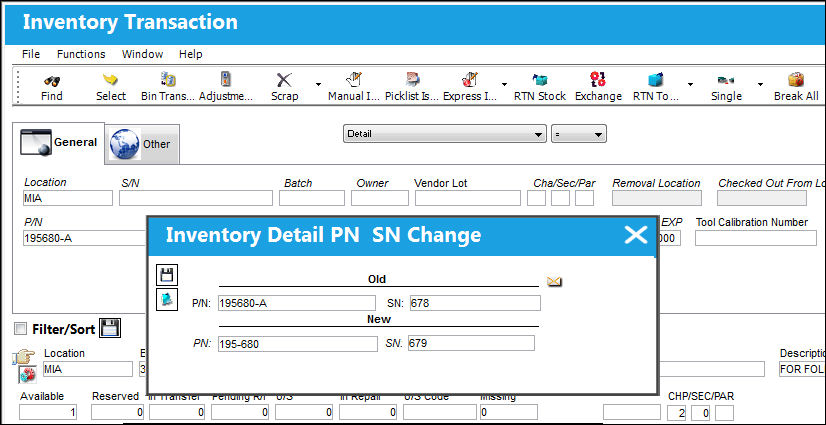

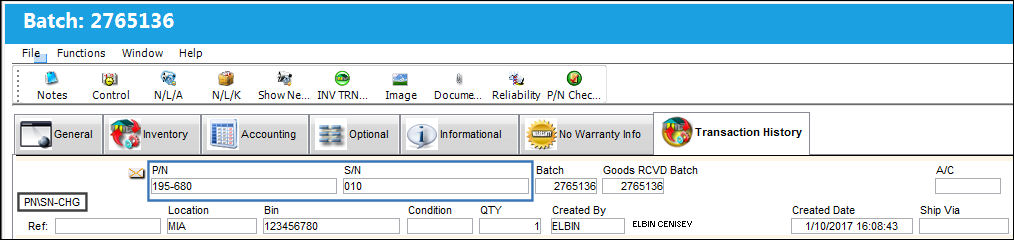

The PN\SN-CHG transaction is reflected from the Transaction History tab.
The new P/N has been made effective to the E/C and the schedule of the E/C.
The new P/N is also added to the list of effective P/Ns in the Engineering Effectivity Override window.

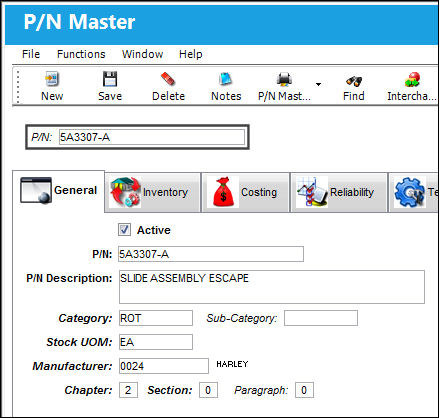

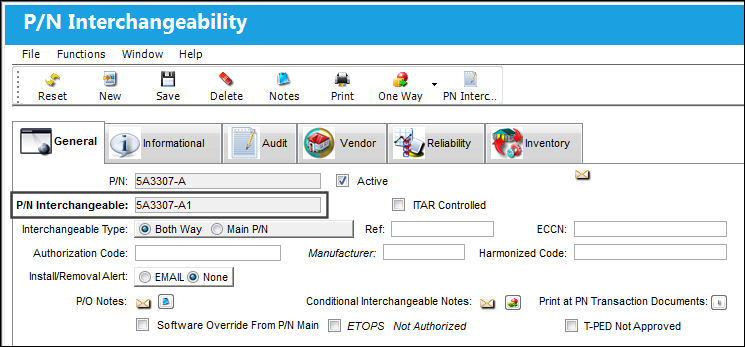

Example 2: Transfer Override Schedule The following P/N is a Main P/N.

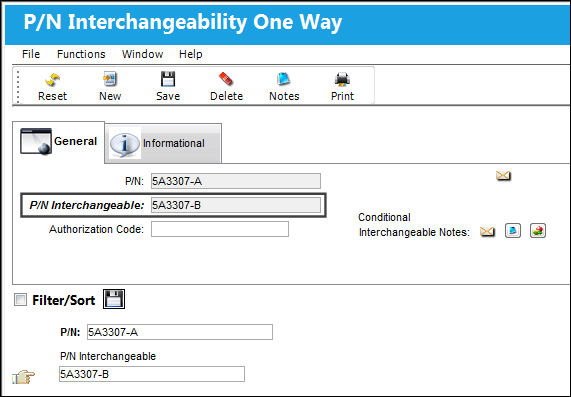

P/N 5A3307-A1 is a Both Way Interchangeable to the Main P/N.
The Main P/N is a One Way Interchangeable to P/N 5A3307-B.

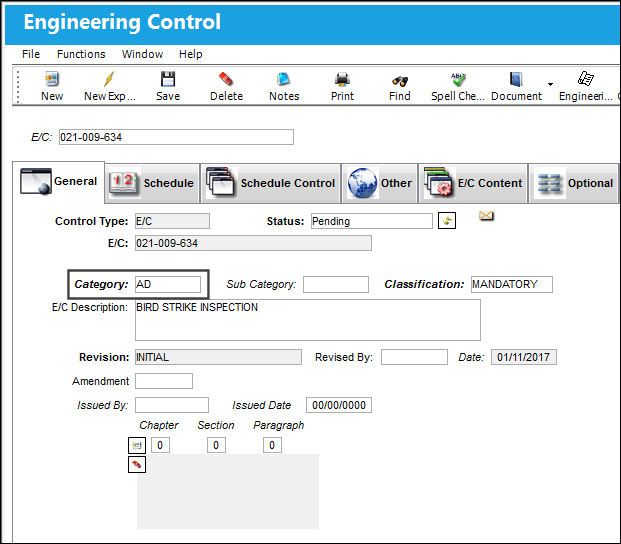

The following E/C was created with E/C Category Code AD:
Note the schedule for the E/C:

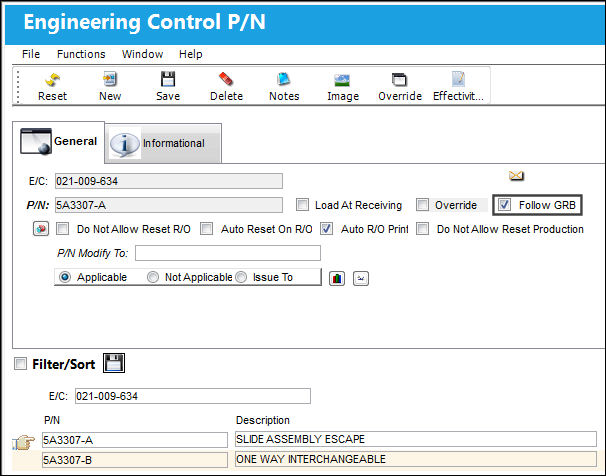

From the Engineering Control P/N window, the Follow GRB checkbox is selected by default.

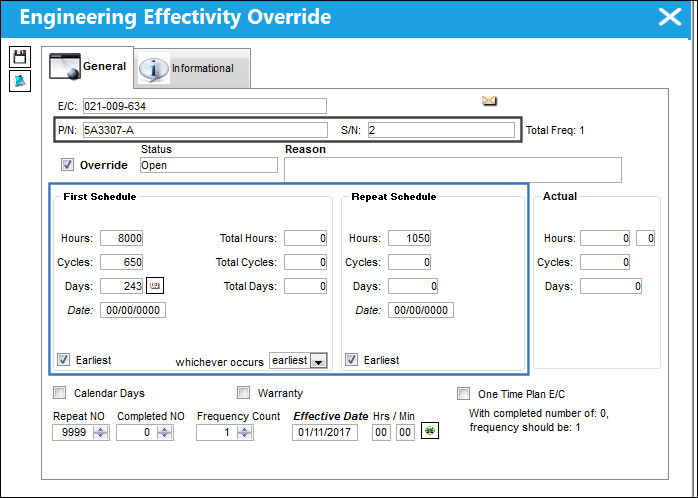

The following Override schedule is applied to the Main P/N S/N.

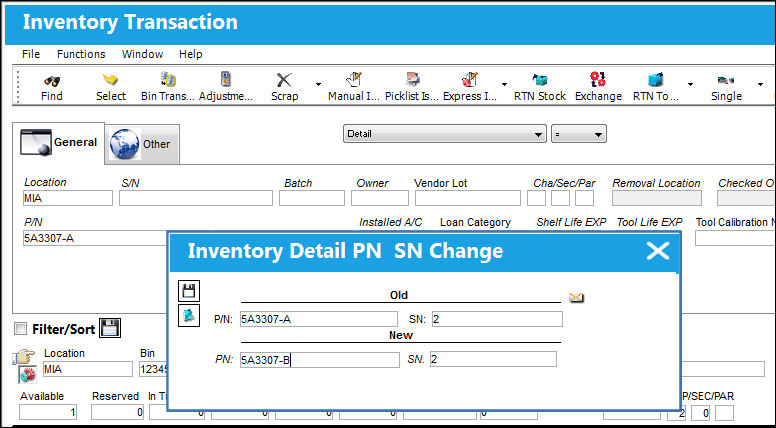

A P/N S/N Change transaction is done for the Main P/N 5A3307-A. This is the P/N effective to E/C 021-009-634.
The One Way Forward P/N S/N has acquired the Override schedule from the Main P/N S/N.

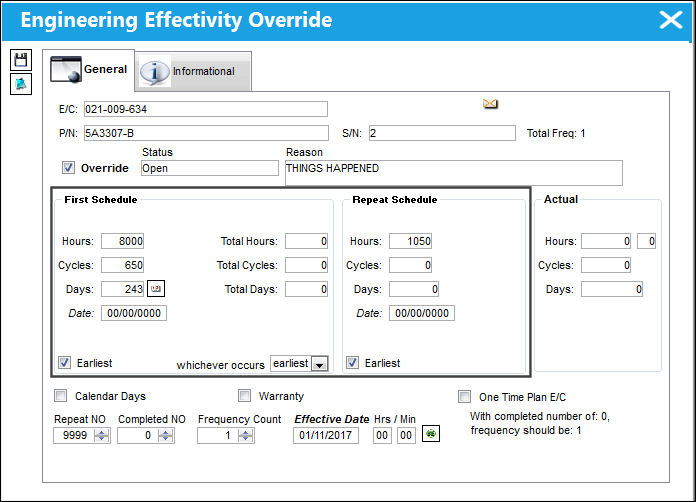

The Override Schedule is reflected correctly for the One Way Forward.
This functionality also works for Both Way Interchangeable parts.
Switch Set to No: When set to No, the Follow GRB checkbox and the Load At Receiving checkbox will not be available on the Engineering Control P/N window. The system will not track the E/C for that GRB regardless of any changes made to any P/N S/N effective to that E/C.
The Follow GRB checkbox and the Load At Receiving checkbox are not available for selection via the E/C Category Transaction Code.

The following E/C was created with E/C Category Code AD:

The Follow GRB checkbox is not available via the Engineering Control P/N window for the following P/N E/C.

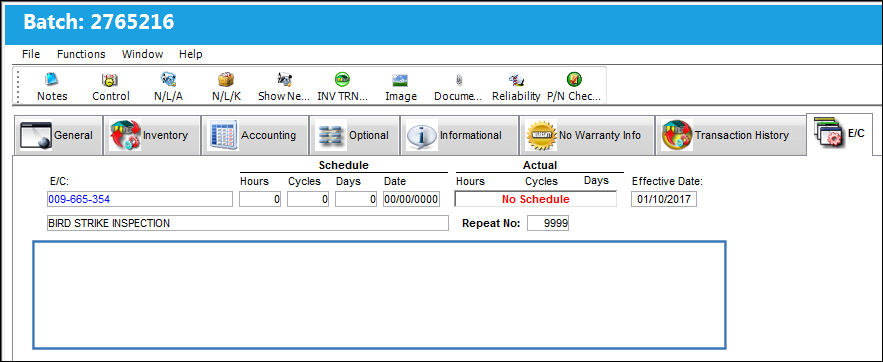

A P/N S/N Change transaction is done for P/N 195680-A. This is the P/N E/C effective to E/C 008-768-009.

The new P/N is not made effective to the E/C.
The P/N was not added to the list of effective P/N E/Cs.
|
||||||
